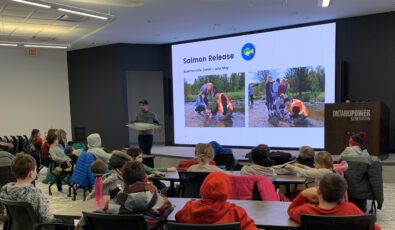

Students attend a presentation about the Bring Back the Salmon Lake Ontario Atlantic Salmon Restoration Program.
OPG is proud to be a lead sponsor of the Bring Back the Salmon Lake Ontario Atlantic Salmon Restoration Program.

In January, grades four, five and six students from Central Public Elementary School in Bowmanville, and Biidaasige Mandamin Elementary School in Pickering, joined OPG and OFAH staff for the launch of our two educational salmon hatcheries at the Darlington Nuclear Information Centre. Each hatchery is now home to 100 salmon eggs.

Over the winter and spring months, students will track progress of the eggs with the help of local Conservation Authorities as part of OPG’s outreach and educational component of the program. In late spring, they will release the fry (young salmon) into both Pickering’s Duffins Creek and the Bowmanville Creek.

Public support is key to the achievement of this historic restoration effort.

Accent: t45xu1zfbo6i
Kenetic_right

The Darlington Refurbishment Project - Canada’s largest clean-energy initiative

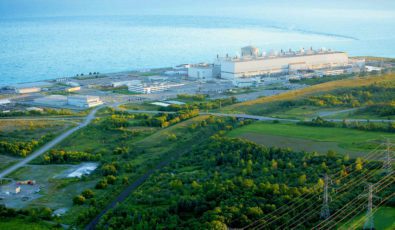

An aerial view of Darlington Nuclear Generating Station.
Darlington Nuclear Generating Station

After successfully completing the first of four units, the Darlington Refurbishment Project is into the final half of the 10-year execution, with Darlington Units 3 and 1 undergoing refurbishment execution at the same time.

Once complete, this project will enable production of clean, safe, low-cost, and emission-free electricity from the Darlington station for an additional 30-plus years. With detailed planning, quality workmanship and the dedicated support of OPG’s skilled workforce, our project partners, suppliers, contractors, and Ontario’s robust nuclear supply chain, we look forward to completing the project safely, on schedule, and on budget.

Learn more at opg.com/darlingtonrefurb

OPG helps “Be the Roar” in Durham Region

OPG was pleased to once again sponsor the Ontario Parasport Games which took place this past February at various venues throughout the Durham Region.

Puck drop at the a 2023 Parasport Sledge Hockey game.
2023 Parasport Sledge Hockey

The Ontario Parasport Games were first delivered in 1975 by the City of Cambridge. Since then, the games have grown to more than 500 participants competing in 10+ sports. The Parasport Games celebrate inclusiveness and accessibility as well as the dedication and commitment of the athletes.

OPG’s very own Spot the Robot Dog performed the ceremonial puck drop at the sledge hockey game and was on hand with OPG employees, family, and friends to cheer on athletes and “Be the Roar.” The games were held at various sporting events across the community, including at the Abilities Centre, one of the many local sponsors of the games.

Accent: 61ajvg2bht5y
Kenetic_04

Darlington New Nuclear Project

Site preparation work continues

The Darlington New Nuclear Project team has continued with site preparation activities since it began in October 2022. This work consists of non-nuclear infrastructure activities, such as clearing and grading a portion of the new nuclear site to build roads, utilities, and support buildings.

In support of this work, OPG is constructing a roadway on the eastern portion of the Darlington Nuclear site. To prioritize the safety of users, the Darlington Waterfront Trail will be diverted away from the construction and rerouted along Energy Drive; access to the trail will remain available on this rerouted path. The portion of the trail west of Hold Rd. will not be impacted. OPG will seek to reestablish full access to the trail in stages when it is safe to do so.

Learn more at opg.com/newnuclear

DNNP in the community

0 42

responses to pubic inquiries from websites, phone calls and emails

0 218

individuals registered for our Public Information Sessions

0 2400

people attended our Community Open House in 2022

0 20

community events attended in the Durham Region in 2022

0 17

gatherings with community committees in 2022

DNNP project timeline

Project Status: UnderwayStart Date: 2022Expected Completion: TBD

Click on 🛈 below to read more information on milestones.

2022
September 2022
Ontario asks OPG to seek CNSC approval to operate Pickering until Sept. 2026
DNNP project timeline
September 2022
Ontario asks OPG to seek CNSC approval to operate Pickering until Sept. 2026
  • The province asks OPG to seek approval from the Canadian Nuclear Safety Commission (CNSC) to continue operating Pickering’s Units 5-8 to the end of September 2026 and to conduct a comprehensive technical review on the potential for refurbishing Units 5-8.
December 2022
OPG submits notice of intent
DNNP project timeline
December 2022
OPG submits notice of intent
  • OPG submitted a notice of intent to the Canadian Nuclear Safety Commission (CNSC) to operate Pickering Units 5-8 to September 2026.
Summer 2023
OPG submits Pickering refurbishment feasibility study
DNNP project timeline
Summer 2023
OPG submits Pickering refurbishment feasibility study
  • Submission of the Pickering refurbishment feasibility study to the Ministry of Energy
June 2023
OPG submits updated licence application to CNSC
DNNP project timeline
June 2023
OPG submits updated licence application to CNSC
  • OPG submitted the Licence Amendment Application to the CNSC supporting operating Units 5-8 to 2026.
December 2023
CNSC midterm licence review
DNNP project timeline
December 2023
CNSC midterm licence review
  • The CNSC conducted a standard midterm licence review.
January 2024
Province of Ontario announces support for Pickering Refurbishment
DNNP project timeline
January 2024
Province of Ontario announces support for Pickering Refurbishment

The Province of Ontario announced support for Pickering Refurbishment.

June 2024
CNSC holds public hearing to consider Pickering licence application
DNNP project timeline
June 2024
CNSC holds public hearing to consider Pickering licence application
  • The CNSC held a public hearing to consider the Pickering Nuclear application for operating Pickering Units 5-8 to 2026.
October 2024
Pickering Unit 1 taken offline and placed into safe storage
DNNP project timeline
October 2024
Pickering Unit 1 taken offline and placed into safe storage
  • Pickering Unit 1 taken offline. Unit 1 will be defueled, dewatered and safe stated.
December 2024
Pickering Unit 4 taken offline and placed into safe storage
DNNP project timeline
December 2024
Pickering Unit 4 taken offline and placed into safe storage
  • Pickering Unit 4 has been taken offline. The unit will then be defueled, dewatered and safe stated.
2026
Unit 5 to 8 to be taken offline and prepared for refurbishment
DNNP project timeline
2026
Unit 5 to 8 to be taken offline and prepared for refurbishment
  • Unit 5 to 8 will be defueled and dewatered so that refurbishment activities can begin.
Accent: bj1en2ca0ql3
Kenetic_05

An aerial view of Pickering Nuclear Generating Station from Lake Ontario.

Pickering nuclear station

As Ontario’s other nuclear stations undergo refurbishment, there is a need for additional electricity through to 2026. OPG is seeking the CNSC’s approval through a public hearing process to operate Pickering’s Units 5 - 8 to September 2026, while Units 1 and 4 will cease operations at the end of 2024.

OPG’s corporate headquarters

OPG announced plans to locate its new Corporate Headquarters at the former GM Building in the Region of Durham. OPG had previously announced plans to construct a new headquarters in the Clarington Energy Park, adjacent to its Darlington Energy Complex. OPG revisited its plan when an economical, sustainable option of repurposing an existing building became available.

A lot has changed over the last three years, but what hasn’t changed is our commitment to bringing our team together under one roof to create an even more connected and engaged workforce. Renovating and repurposing a suitable existing building makes sense from both an economic and environmental perspective. We look forward to welcoming employees to our new headquarters in Durham Region.
Ken Hartwick
OPG President and CEO

With OPG’s advancement of Small Modular Reactors (SMRs), nuclear generation, isotope production, and other clean energy technologies, the Darlington site has become an international destination.

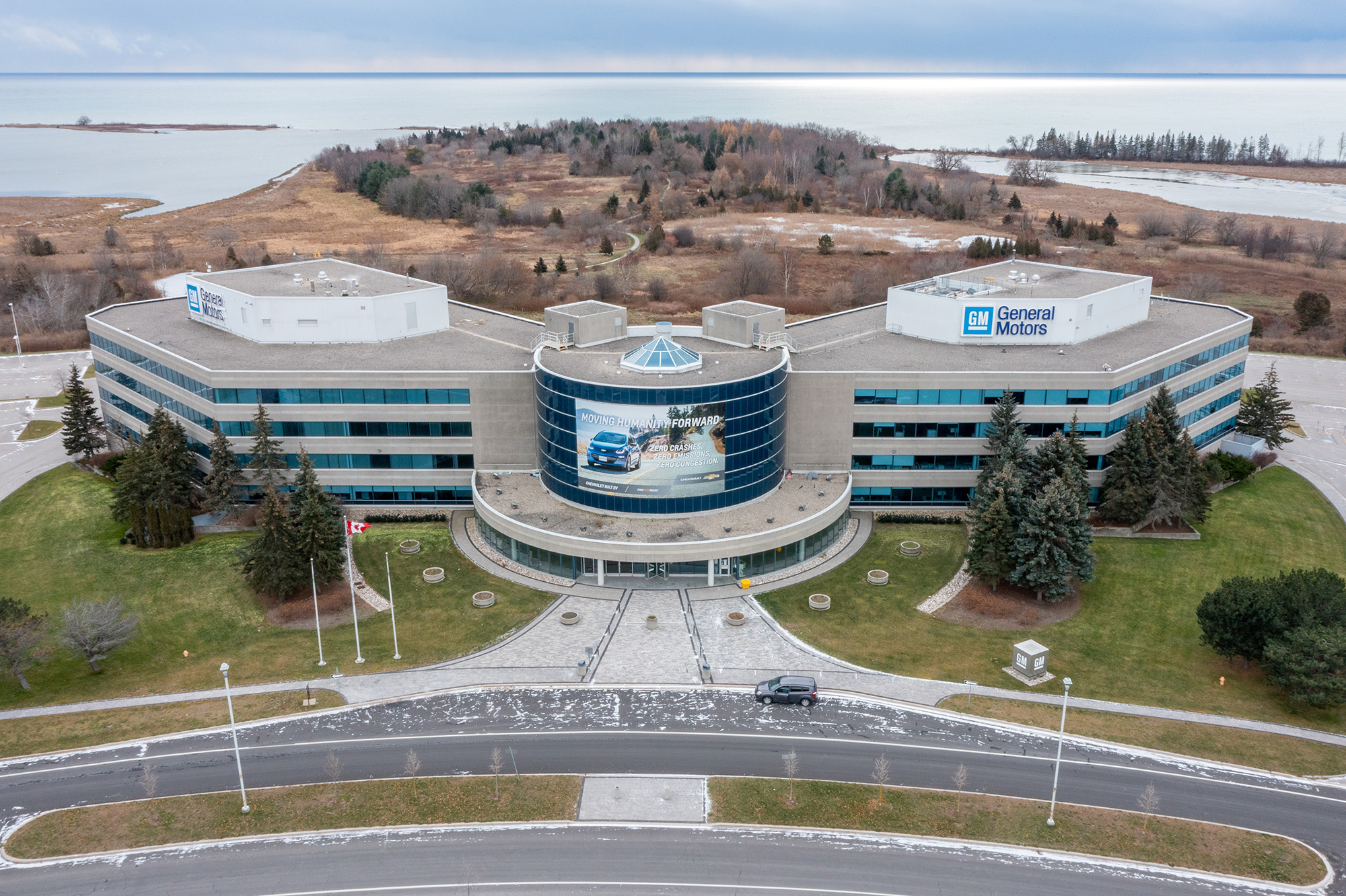

An aerial view of OPG's new future headquarters in Durham region.
